CPP vs PCPP — What's the Difference?

Construction Phase Plan vs Pre-Construction Phase Plan — what's the difference, who writes them, and when are they needed? A CDM 2015 guide for contractors.

5 min read

ND
Nicola Dobbie·Founder, The Site Book

The Simple Answer

  • PCPP (Pre-Construction Phase Plan) — written by the Principal Designer before work starts. It covers design risks and high-level planning.
  • CPP (Construction Phase Plan) — written by the Principal Contractor (or contractor) during the work. It's the practical H&S plan for the build.

Who Writes What?

DocumentWritten ByWhen

PCPPPrincipal Designer (architect, engineer, or designer)Before construction starts
CPPPrincipal Contractor (main contractor or builder)Before work starts, updated throughout

What's in a PCPP?

The PCPP (also called the Pre-Construction Information or PCI) includes:

  • Description of the project
  • Client requirements and management arrangements
  • Environmental restrictions (protected species, TPOs, archaeology)
  • Existing site hazards (asbestos, contamination, services)
  • Design risks and how they'll be managed
  • Health and safety file information

It's mostly information — what the contractor needs to know before pricing and starting work.

What's in a CPP?

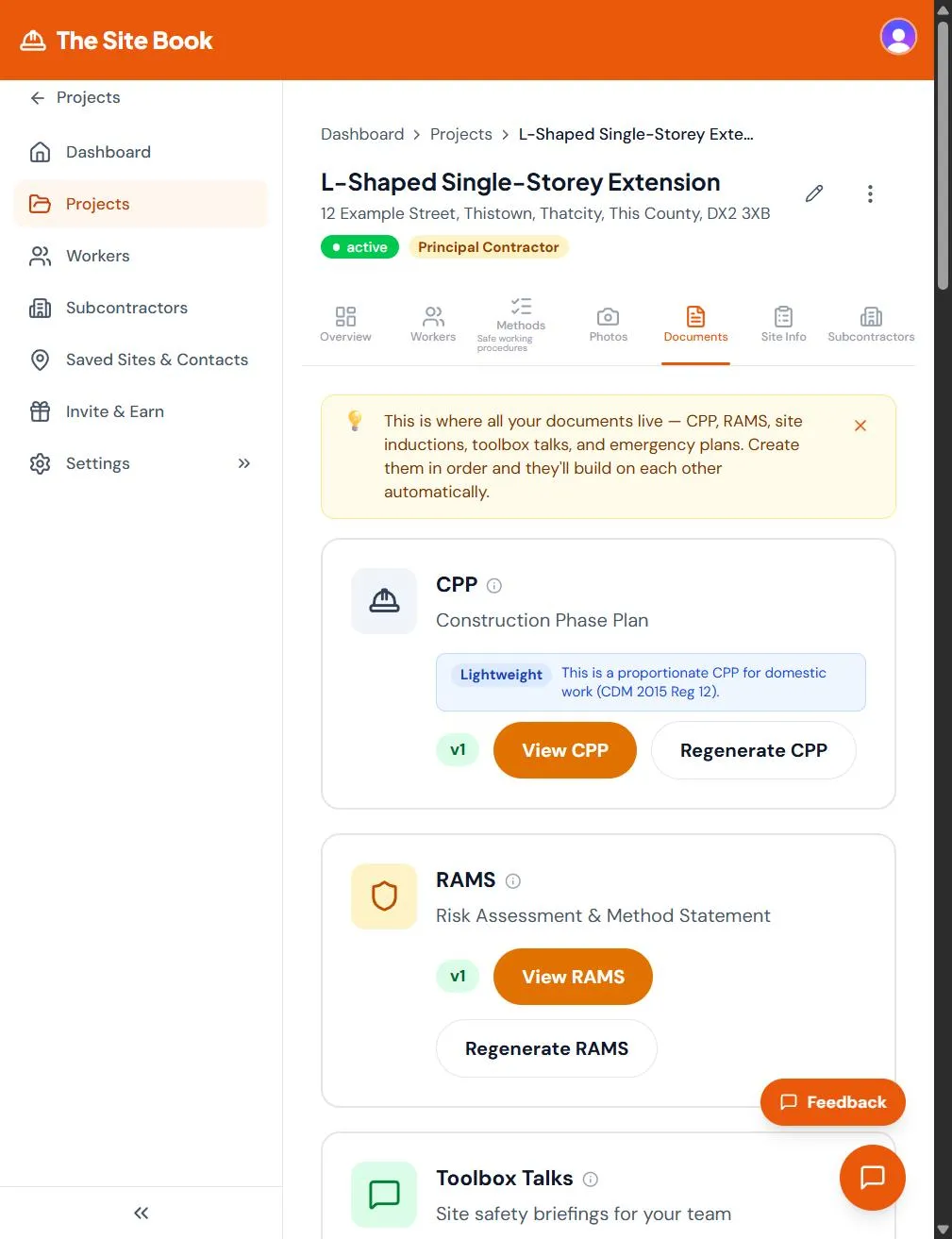

The CPP is the contractor's practical safety plan:

  • Site rules and induction requirements
  • Welfare facilities (toilets, drinking water, rest area)
  • Emergency procedures (fire, first aid, accident reporting)
  • Site-specific risks and controls
  • Method statements and RAMS for key activities
  • Site layout and traffic management
  • Consultation and communication arrangements
  • Monitoring and review procedures

It's a working document — you update it as the job progresses.

Do I Need Both?

If the project is notifiable to HSE (>30 working days OR >500 person-days), yes — you need both under CDM 2015.

For smaller projects, you still need a CPP. The PCPP might be as simple as a brief from the client or designer.

Domestic Projects

For domestic clients (homeowner having work done on their own house), CDM 2015 doesn't apply. But you should still write a CPP as good practice — it shows you've thought about safety and protects you if something goes wrong.

Example Scenario

Project: Single-storey rear extension on a domestic property.

  • PCPP: Architect provides drawings, notes asbestos in existing garage roof, warns of foul drain running across site.
  • CPP: Builder writes a plan covering welfare (portaloo), emergency contacts, site rules, excavation procedure, asbestos removal by licensed contractor before demolition, services location before digging.

The PCPP told the builder what to watch out for. The CPP is the builder's plan for managing those risks.

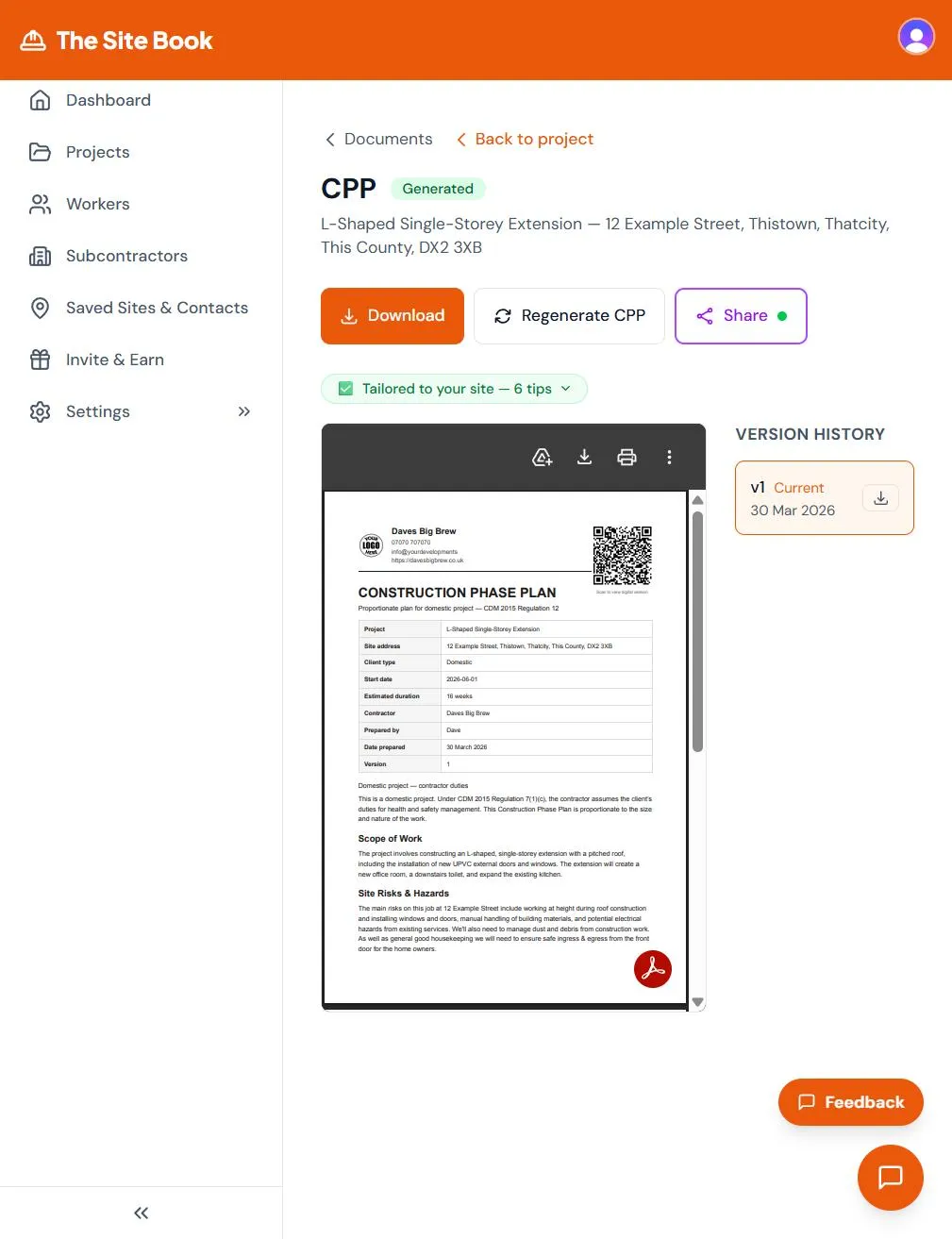

Generate your CPP →

Ready to sort your compliance?

The Site Book handles RAMS, CPP, site inductions, and everything else. All in one place.

Try The Site Book →

More articles

The Site Book now integrates with Google Drive, Xero, and Zapier

The Site Book now connects with Google Drive, Xero, and Zapier. Export your RAMS and compliance docs to Drive, sync jobs with Xero, and automate your workflows with 5,000+ apps.

RAMS for Roofers — What You Actually Need

A practical guide to writing a Risk Assessment and Method Statement for roofing work. Covers pitched roofs, flat roofs, scaffolding, fragile surfaces, and what HSE inspectors look for.
